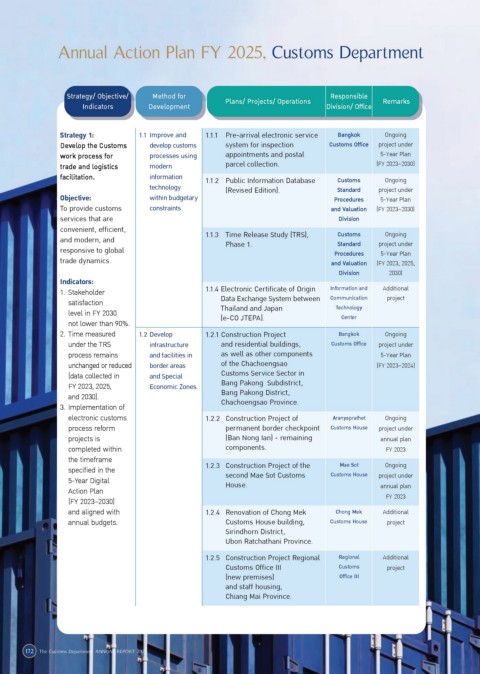

Annual Action Plan FY 2025, Customs Department
Strategy/ Objective/ Method for Plans/ Projects/ Operations Responsible Remarks
Indicators Development Division/ Office
Strategy 1: 1.1 Improve and 1.1.1 Pre-arrival electronic service Bangkok Ongoing
Develop the Customs develop customs system for inspection Customs Office project under
work process for processes using appointments and postal 5-Year Plan
trade and logistics modern parcel collection. (FY 2023–2030)
facilitation. information 1.1.2 Public Information Database Customs Ongoing
technology (Revised Edition). Standard project under
Objective: within budgetary Procedures 5-Year Plan
To provide customs constraints. and Valuation (FY 2023–2030)
services that are Division
convenient, efficient,
Ongoing
and modern, and 1.1.3 Time Release Study (TRS), Customs project under
Standard
Phase 1.
responsive to global Procedures 5-Year Plan
trade dynamics. and Valuation (FY 2023, 2025,
Division 2030)
Indicators:
1. Stakeholder 1.1.4 Electronic Certificate of Origin Information and Additional
satisfaction Data Exchange System between Communication project
level in FY 2030 Thailand and Japan Technology
Center
(e-CO JTEPA).
not lower than 90%.
2. Time measured 1.2 Develop 1.2.1 Construction Project Bangkok Ongoing
under the TRS infrastructure and residential buildings, Customs Office project under
process remains and facilities in as well as other components 5-Year Plan
unchanged or reduced border areas of the Chachoengsao (FY 2023–2024)
(data collected in and Special Customs Service Sector in
FY 2023, 2025, Economic Zones. Bang Pakong Subdistrict,
and 2030). Bang Pakong District,
3. Implementation of Chachoengsao Province.
electronic customs 1.2.2 Construction Project of Aranyaprathet Ongoing
process reform permanent border checkpoint Customs House project under
projects is (Ban Nong Ian) - remaining annual plan
completed within components. FY 2023
the timeframe
specified in the 1.2.3 Construction Project of the Mae Sot Ongoing
5-Year Digital second Mae Sot Customs Customs House project under
House.
Action Plan annual plan
(FY 2023–2030) FY 2023
and aligned with 1.2.4 Renovation of Chong Mek Chong Mek Additional
annual budgets. Customs House building, Customs House project
Sirindhorn District,
Ubon Ratchathani Province.
1.2.5 Construction Project Regional Regional Additional
Customs Office III Customs project
(new premises) Office III
and staff housing,
Chiang Mai Province.
